Penerapan Metode Earned Value Untuk Manajemen Pembangunan Pabrik PT. Swanson Plastics Indonesia

Afan, Moh. Midchol and Sarya, Gede (2018) Penerapan Metode Earned Value Untuk Manajemen Pembangunan Pabrik PT. Swanson Plastics Indonesia. Undergraduate thesis, UNIVERSITAS 17 AGUSTUS 1945.

[img] Text
ABSTRAK.pdf

Download (2MB)
[img] Text

BAB I.pdf

Download (775kB)
[img] Text

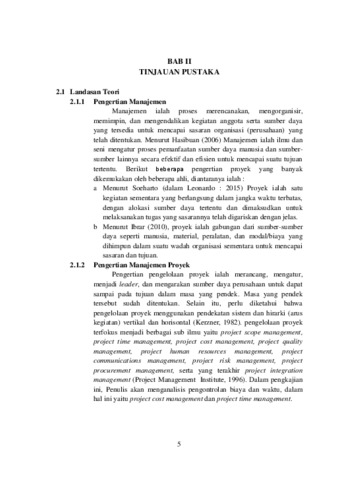

BAB II.pdf

Download (890kB)
[img] Text
BAB III.pdf
Restricted to Repository staff only

Download (781kB)
[img] Text
BAB IV.pdf
Restricted to Repository staff only

Download (1MB)
[img] Text

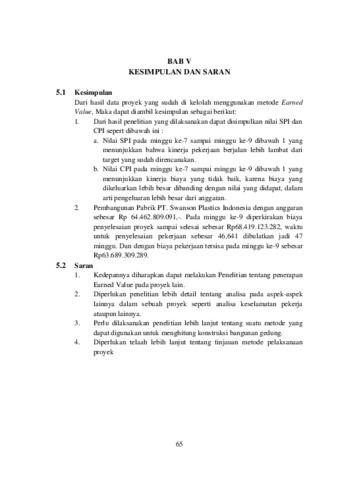

BAB V.pdf

Download (763kB)
[img] Text

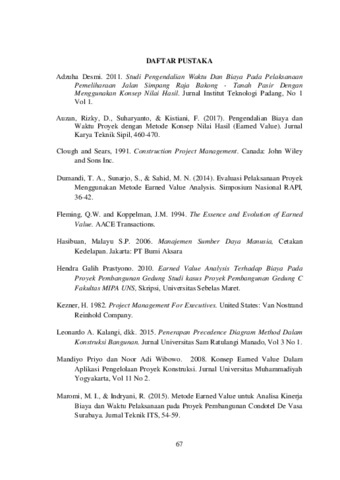

DAFTAR PUSTAKA.pdf

Download (772kB)
[img] Text

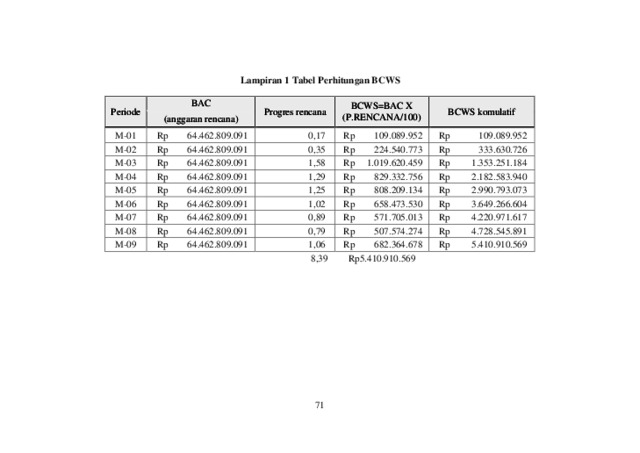

LAMPIRAN.pdf

Download (2MB)
[img] Text

JURNAL.pdf

Download (150kB)
[img] Text
JURNAL TURNITIN.pdf

Download (2MB)

Abstract

Construction project of PT. Swanson Plastics Indonesia was located in Blok D2-D3, Ngoro Industrial Park, Ngoro, Mojokerto, East Java 61385. It was completed in accordance with 40 weeks schedule with a contract value of Rp 64,462,809,091. The helps of time provisions period and cost limits, good and mature project protection were needed. To carry out this control, it must first inform the project that had taken place. The research objective were to determine the cost and time performance, estimated costs and time at the end of the project. The method that be used in this study was the Earned Value method that combined elements of cost and time and physical achievement of work. Data obtained from the project include Cost Budget Plan (RAB), project Timetable, project reports and actual costs which were then carried out a schedule, cost, variance and performance index analysis. All of that described the problems that arised during the research. From the results of the analysis carried out at the 9th week, the costs incurred were greater than the budgeted costs with the CPI value = 0.94 and the implementation time was more than the results with SPI = 0.82. The results of the final project investment cost of Rp. 68,419,123,282, - with an estimated time of 47 weeks, indicate that the project is 7 weeks out of 40 weeks. This delay was caused by the late of delivering materials that be used.

Item Type: Thesis (Undergraduate)
Uncontrolled Keywords: Earned Values, cost and time
Subjects: T Technology > TA Engineering (General). Civil engineering (General)
Divisions: Fakultas Teknik > Magister Teknik Sipil
Depositing User: Aprianto Doni Rahmat
Date Deposited: 25 Feb 2019 06:02
Last Modified: 18 Jul 2022 02:42
URI: http://repository.untag-sby.ac.id/id/eprint/1394

Actions (login required)

View Item View Item
